Installation Report
DVIA-ULF Series
12-19-2022
XZZJS ZEISS SEM DVIA-U1000 (200828R3) Installation Report — Shanghai
DVIA-U Series
Installation Report
XZZJS
ZEISS
SEM
Shanghai
Xuzhou
DVIA-U1000
200828R3
Contents
XZZJS
XZZJS
(U1000_ 200828R3 Set up)
Site checklist
| Target equipment | ZEISS SEM |
|---|---|
| Place of installation | Shanghai |
| Remark | Good Performance |
| END USER | XZZJS |
Operator and dates
| Operator: Yu, Ho Sang Date of setup : 22.12.13 Date of reporting : 22.12.19 | Date of business trip : 17.12.27~17.12.29 |
|---|
Overview

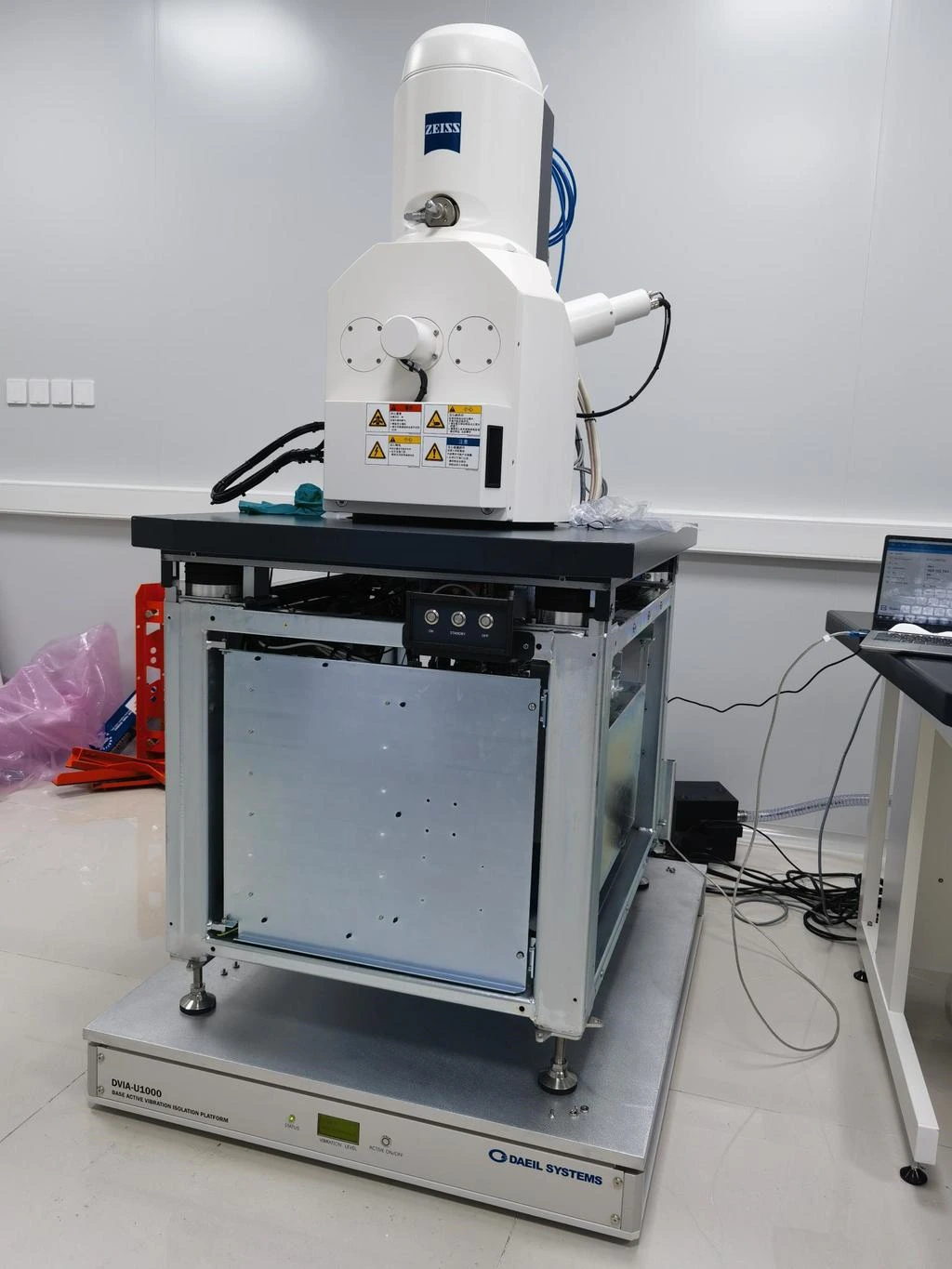

The DVIA-U1000 active vibration isolation platform is appropriately installed and functioning as intended. Measurement date: 2022.12.13 (Tuesday), Operator: DAEIL SYSTEMS, Hosang Yu Place of measurement: Xuzhou, China Equipment Model: ZEISS SEM
U1000 internal program performance measurement result

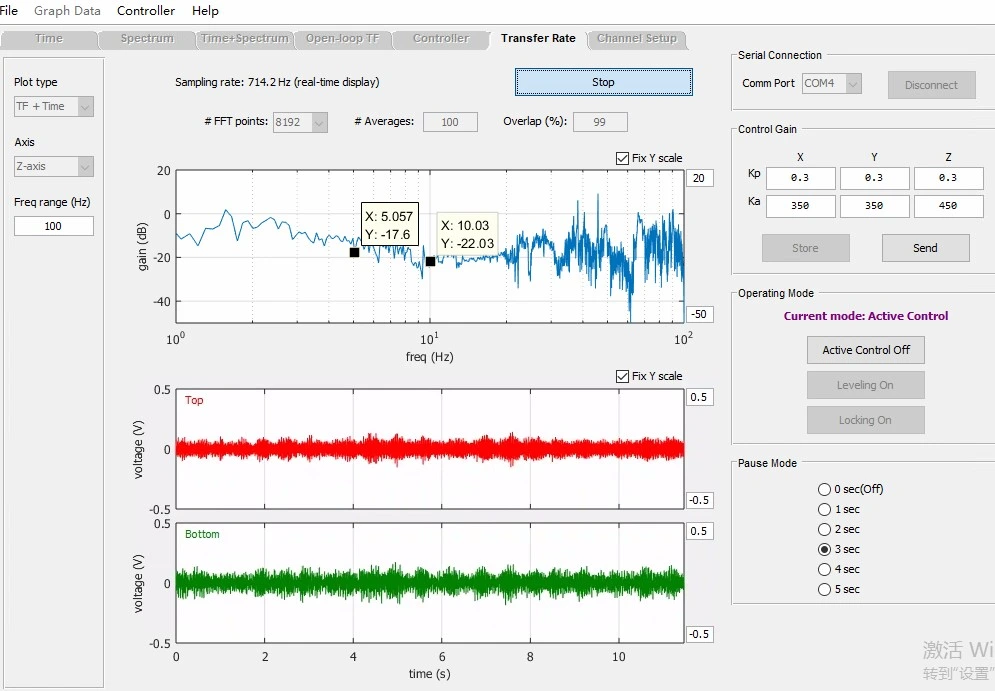

Z axis

X axis

Y axis
Share this Case Study
Case Study Information
Category
Installation Report
SeriesDVIA-ULF Series
Date12-19-2022
Tags
DVIA-U Series
Installation Report
XZZJS
ZEISS
SEM
Shanghai
Xuzhou
DVIA-U1000
200828R3
Related Case Studies

DVIA-ULF Series
Shanghai Tight Welding Institute ZEISS SEM EVO10 DVIA-U1000 (241217R6) Installation Report — Shanghai
04-17-2025Read more
DVIA-ULF Series
XZZJS ZEISS SEM DVIA-UB700 (200828R3) Installation Report — Xuzhou
12-19-2022Read more

DVIA-ULF Series
Shanghai ZEISS Sigma360 DVIA-U1000 (250114R3) Installation Report
04-18-2025Read more
